Local service guide

Kitchen remodeling in San Jose: Plan and Hire

Masters' Guild · Updated

Kitchen remodeling in San Jose starts with a scope that competing contractors can price: your layout, cabinets, appliances, utility work and cleanup. Choose a bidder who explains exclusions and puts permit responsibility, payments and completion dates in writing. If you want electric cooking, check San José Clean Energy eligibility before authorizing installation. Ask contractors for prices and schedules specific to your kitchen. [1] [2]

Give contractors a scope they can price

Decide which parts of the kitchen you want to keep. Mark proposed changes to the sink, cooking area, refrigerator and cabinets on a floor plan. List your priorities, such as more usable storage or a different appliance arrangement, and separate essential work from optional upgrades.

Send each bidder the same cabinet specifications, countertop selection and appliance model numbers. Request separate amounts for removal, materials, installation, electrical work, plumbing and cleanup. For an undecided finish, ask for an allowance and a written explanation of how the contractor will charge for your eventual selection.

Ask each contractor for a scope-specific price and schedule. Have them identify unresolved conditions, purchasing deadlines and the point when you will lose kitchen access. Choose a reserve you can afford for approved changes, and ask how the contractor will document unexpected work before proceeding.

Compare the contract as well as the bid

CSLB says California home-improvement projects over $500 require a written contract. The agreement should identify the contractor, business address and license number, describe the products and work, assign responsibility for necessary permits and provide a completion date. Get any offered labor or material warranty in writing. [2]

For home-improvement work, CSLB limits the down payment to $1,000 or 10 percent of the contract price, whichever is less, excluding finance charges. Special-order materials provide no exception. Apart from the permitted down payment, payments cannot exceed the value of work performed. [2]

Before signing, request license and insurance information for review. Ask who will supervise the job, which people will perform utility work and how you will reach the supervisor during construction. Have the contractor explain the proposed permit and inspection sequence for your scope.

CSLB requires you and the contractor to sign a written change order before changing the contract price or scope. Ask the contractor to include the revised work, price and any effect on the completion date. Keep signed changes with your agreement. [2]

Plan electric cooking before ordering appliances

San José Clean Energy offers cooking-circuit prewiring and electric service panel upgrades as EcoHome add-ons. Current SJCE customers must pair these with an eligible heat-pump water heater or heat-pump HVAC installation replacing gas equipment. Confirm eligibility before counting a rebate toward your budget. [1]

SJCE specifies 240 volts and 40–50 amps for eligible induction cooktop or range prewiring. It allows one cooking-circuit rebate per home, including homes with a separate cooktop and oven. Give your electrician the selected appliance specifications and ask them to evaluate the proposed circuit and existing panel. [1]

For a panel-upgrade rebate, SJCE requires an existing panel below 200 amps and an upgrade to at least 200 amps. Ask your electrician to document the existing capacity and explain the work your appliance plan requires. Keep the electrical scope separate from the rebate amount when comparing bids. [1]

Resolve tear-out questions before scheduling

Ask your contractor which existing materials the project will disturb and how they will determine any asbestos-related obligations. Assign responsibility for assessment, removal and applicable notifications before authorizing tear-out. Request an explanation of any regulatory lead time included in the proposed schedule.

The Bay Area Air District publishes notification rules for work within its jurisdiction. Its standard notice period is at least 10 business days before renovations removing 100 square feet or more, 100 linear feet or more, or 35 cubic feet or more of asbestos, and before every demolition regardless of asbestos content. For residential buildings with four or fewer dwelling units, the district allows 72-hour advance notification with payment of an additional fee. Contact the district to confirm jurisdiction, the classification of your proposed work and the applicable notice option before setting your schedule. [3]

Describe the actual work when seeking that confirmation: cabinet removal, flooring removal, wall changes or building demolition. Ask who must submit any notice and who will update dates if work shifts. Avoid treating a contractor's use of the word demolition as a regulatory determination.

Arrange kitchen access and collect closeout records

Agree on working hours, delivery access, material storage and debris removal. Set up a temporary food-preparation area. Ask when you will lose the sink, refrigerator and cooking equipment, and name the decisions you must make before the crew starts each stage.

Walk through the completed kitchen with the contractor and record unfinished items. Collect manuals, written warranties and relevant permit closeout records. For an EcoHome claim, SJCE requires an itemized final invoice, proof of final permitting and photos of the new equipment. [1]

SJCE kitchen-related EcoHome add-on rebates

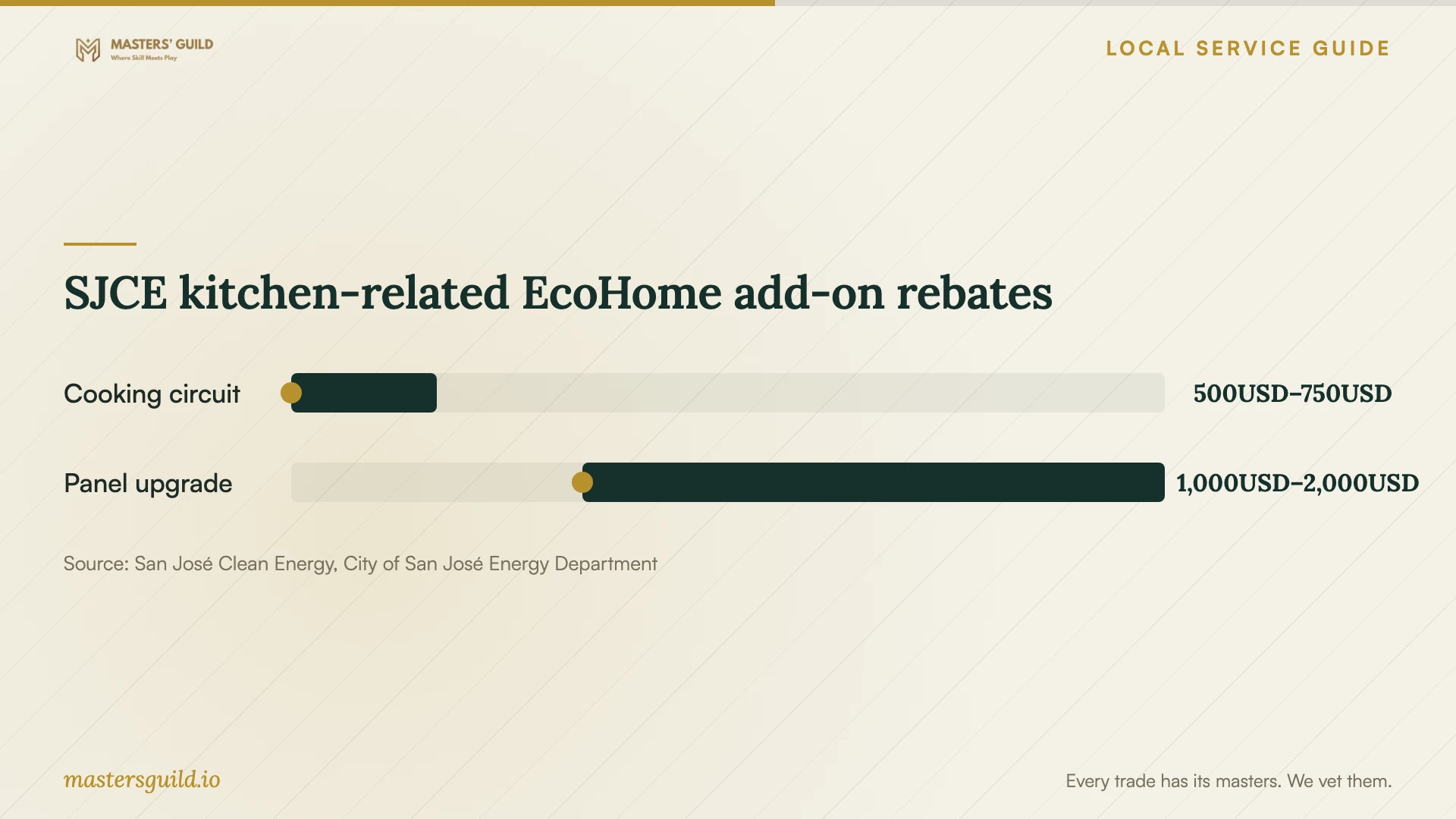

SJCE kitchen-related EcoHome add-on rebates. Data table follows.
Eligible San José Clean Energy customer residences · Published amounts retrieved October 11, 2026. These are two published program benefits, not a sample of remodel bids. Amounts are in US dollars. Each range connects the standard and Environmental Justice Community amounts: cooking-circuit prewiring is $500 or $750; panel upgrades are $1,000 or $2,000. These are discrete eligibility categories rather than continuously available awards. Both require a qualifying heat-pump installation and program approval before planned installation. Enhanced amounts depend on program qualifications. The figures describe potential rebates and do not establish construction prices or guaranteed savings. [1]
SJCE kitchen-related EcoHome add-on rebates (USD)
ItemRangeSource
Cooking circuit500–750 [1]
Panel upgrade1000–2000 [1]

Local details that affect your job

Confirm the paired project before budgeting for a rebate

SJCE customers cannot claim cooking-circuit prewiring or panel-upgrade rebates as standalone projects. Pair either with a qualifying gas-to-heat-pump water-heater or HVAC replacement. Before choosing a kitchen-only electrical bid, ask whether you intend to undertake that separate equipment replacement and confirm eligibility with SJCE. [1]

Coordinate approval and installation dates

For your planned remodel, arrange SJCE rebate approval before installation begins. SJCE reserves approved funds for 120 days. Assign one person to coordinate the kitchen electrician and heat-pump installer around the reservation. If delays threaten that window, contact the program about an extension; SJCE does not guarantee funds beyond the reservation period. [1]

Confirm the residential notification option

The Bay Area Air District allows 72-hour advance notification for residential buildings with four or fewer dwelling units when the applicant pays an additional fee. Before relying on that option for kitchen tear-out, confirm that the district covers your address and determine how it classifies your work. Ask the contractor to identify the notice period and any additional fee in the proposed schedule and scope. [3]

Choose the next step for your project

Your situationNext stepDetail to resolve
You want to retain the layoutRequest a bid identifying retained items and replacement specifications.Ask contractors to price the same scope.
You want induction without a paired heat-pump replacementBudget the circuit work without an EcoHome add-on rebate.SJCE requires a qualifying paired heat-pump installation.
A bidder includes a panel rebateConfirm existing capacity and the proposed upgrade.SJCE requires a panel below 200 amps upgraded to at least 200 amps.
You plan a paired heat-pump projectCoordinate program approval before planned installation.SJCE reserves approved funds for 120 days.
A contractor requests a large custom-cabinet depositCompare the request with CSLB's down-payment limit.Special-order materials provide no exception.
[1] [2]

Your hiring checklist

  1. Send each bidder the same layout, retained-item list and product specifications.
  2. Request fixed prices, allowances, exclusions and a scope-specific schedule.
  3. Review contractor license and insurance information before signing.
  4. Assign responsibility for permits, inspections and closeout documents.
  5. Confirm material assessment, work classification and applicable notification responsibilities before tear-out.
  6. Coordinate any EcoHome approval with the installers before planned work begins.
  7. Agree on payment milestones, written changes and temporary kitchen access.
  8. Record unfinished items and collect manuals and warranties at handover.

Frequently Asked Questions

Can I get an SJCE rebate for an induction circuit alone?

No. Cooking-circuit prewiring is an add-on requiring an eligible heat-pump water heater or heat-pump HVAC installation. SJCE requires current customer status. For planned installations, obtain program approval before work begins. [1]

How much can a contractor request upfront?

CSLB limits a home-improvement down payment to $1,000 or 10 percent of the contract price, whichever is less, excluding finance charges. Special-order materials do not create an exception. [2]

How should I compare kitchen-remodel prices?

Give bidders identical specifications and ask them to separate fixed prices, allowances and exclusions. Compare permit responsibility, cleanup, utility work and the schedule alongside the total. Ask each bidder to explain unresolved work before you choose.

Does kitchen tear-out require an asbestos notification?

Ask the contractor and relevant regulator to determine obligations for your address and scope. The Bay Area Air District publishes notification conditions for asbestos-removal renovations and demolition. Its standard period is at least 10 business days; residential buildings with four or fewer dwelling units may use 72-hour advance notification with an additional fee. Confirm jurisdiction and work classification before scheduling. [3]

Sources and scope

This guide combines the sources below with practical planning guidance. Figures apply to the stated geography and period; request a written quote for your property.

  1. EcoHome RebateSan José Clean Energy, City of San José Energy Department · San José Clean Energy service customers · Checked 2026-10-11
  2. Learn About Home Improvement ContractsCalifornia Contractors State License Board · California · Checked 2026-10-11
  3. Asbestos Demolition and Renovation Notification / Job NumberBay Area Air District · Bay Area Air District jurisdiction; address coverage requires confirmation · Checked 2026-10-11
