Office Relocation and Setup in Grand Rapids

Masters' Guild · Updated

For Office Relocation and Setup in Grand Rapids, hire against a written inventory, room layout and agreed handover checklist. Assign furniture handling, IT reconnection and any premises alterations to named people before accepting a quote. If your move includes renovations, confirm permit and occupancy requirements with the Development Center before committing to an opening date. [3]

Define what the moving crew will finish

Prepare an inventory by destination room. Include desks, chairs, cabinets, boxed files, printers and equipment that needs special handling. Mark furniture you want dismantled and rebuilt. Give bidders photographs, access measurements and a layout that shows each workstation's destination.

Ask each bidder to identify who will pack, label, disconnect, transport, assemble and reconnect each item. Request evidence of insurance suitable for your commercial move and ask how the provider handles damage reports. Agree who will protect floors and doorways, remove packing materials and approve changes to the job.

Define completion in practical terms: furniture in assigned rooms, components accounted for, boxes at labeled destinations and equipment ready for your IT contact to test. Keep responsibility for passwords, backups and access permissions with a named person on your team.

Compare quotes using the same access plan

Give bidders the same inventory and access instructions for both addresses. Ask the building managers about loading docks, freight-elevator reservations, permitted moving hours, protective coverings and insurance documentation. Identify a contact who can unlock each building and resolve access problems during the move.

Request separate amounts for packing materials, labor, transport, assembly, storage and IT assistance. Ask how the provider charges for waiting, additional truck trips, changed inventories and work outside the agreed hours. Put exclusions and the approval process for extra charges in writing.

Choose between a single move and a phased move based on which teams need to keep working. For a phased plan, name the equipment and files each group needs at each address. Ask the bidder to price that sequence rather than leaving repeat visits undefined.

Arrange curb access before loading day

For loading at city parking meters, submit a reservation at least two business days before the requested start. Identify the preferred meter numbers using the meters or the city's interactive map. The city charges a $10 application fee and $23 per meter per day, including weekends. [1]

Name the person who will submit the application and pass the permit to the driver. The city requires the permit in the vehicle's front window on the curbside and a company logo in the front window. Notify the city if dates change or you cancel; otherwise, it bills the requested reservation. [1]

Discuss pods and other curbside equipment before ordering them. The city requires a Temporary Occupancy Permit for a non-plated vehicle or object that remains in the public right-of-way for short-term private use. For a sidewalk, parking-lane or roadway closure, check the commercial Temporary Occupancy Permit application with the Development Center. [1] [2]

Resolve fit-out and occupancy before scheduling setup

Describe proposed alterations to the Development Center before treating the project as a furniture move. The city lists commercial renovation, electrical, mechanical, plumbing and fire-alarm applications. It also requires a change-of-use permit when you change a property's use without construction. [2]

For commercial renovations, the city requires signed and sealed building plans from a licensed architect or engineer. Licensed contractors must obtain trade permits, and you cannot begin renovations until the city issues the necessary permits. Assign permit coordination to a named contractor and ask for the inspection schedule. [3]

Do not use an initial plan-review estimate as your promised opening date. The city says most reviews take five business days, with longer reviews possible for major projects or during busy spring and summer months. Corrections can require another review. Before reopening a renovated commercial building, obtain the required Certificate of Occupancy after approved final inspections. [3]

Test the office before staff return

Choose an internal move lead to walk through both locations with the crew. At the destination, check furniture placement, missing parts and visible damage before signing the completion record. Photograph concerns and record who will resolve them and by when.

Have your IT contact test internet access, phones, printers and a representative workstation before staff arrive. Keep a list of unresolved problems with an owner for each. Complete a final sweep of the old office for keys, documents, cables and equipment that your team intends to retain.

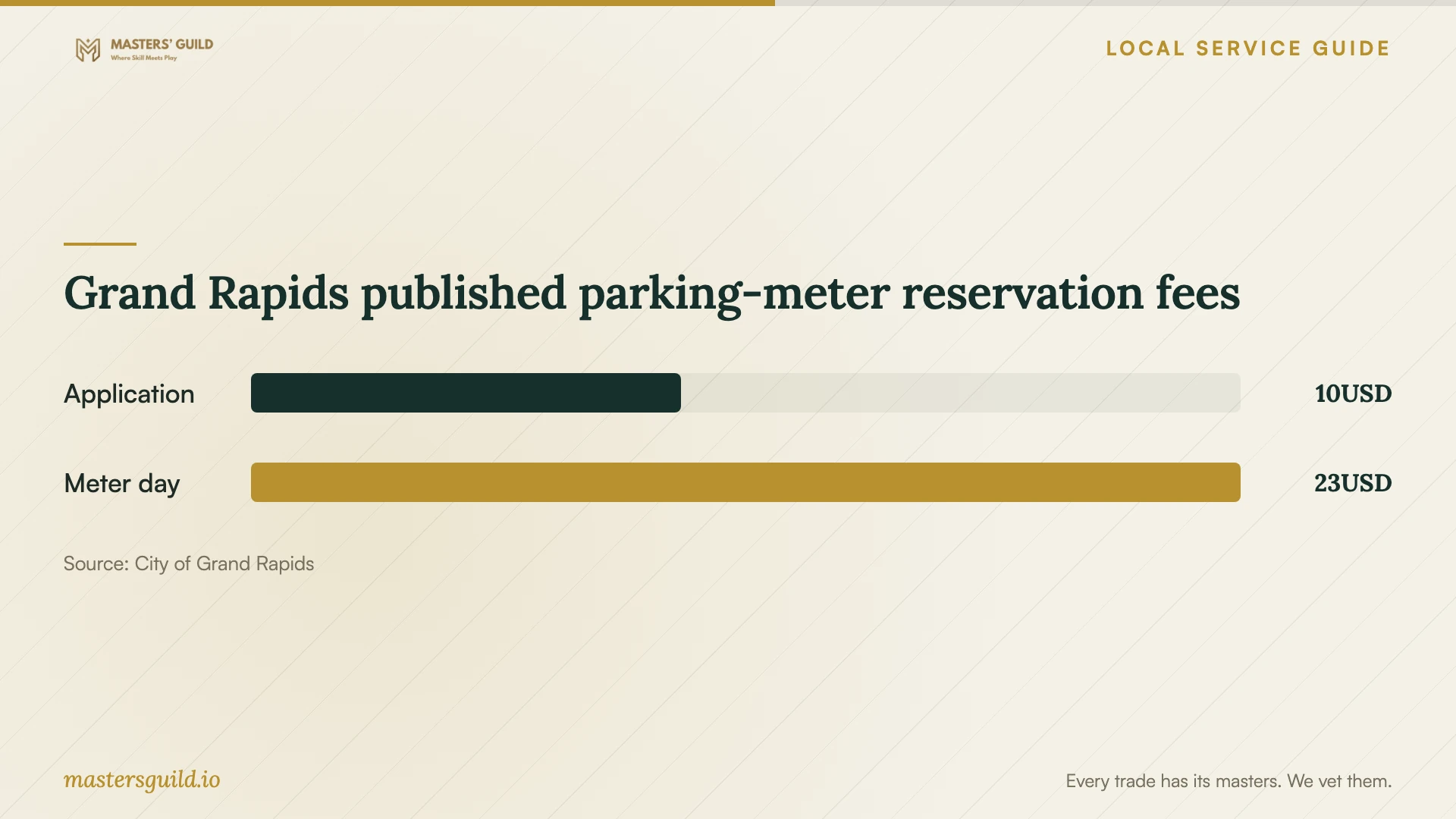

Grand Rapids published parking-meter reservation fees

Grand Rapids published parking-meter reservation fees. Data table follows.
City of Grand Rapids, Michigan · Published fees retrieved October 15, 2026. These are the two fee components published by the city for meter reservations, expressed in US dollars. Application means per application; meter day means per meter per requested day, including weekends. Add the application charge to the daily meter charges for your reservation. These figures cover curb access, not moving labor, transport or separate permit costs. They do not establish an office relocation price. [1]
Grand Rapids published parking-meter reservation fees (USD)
ItemValueSource
Application10 [1]
Meter day23 [1]

Local details that affect your job

Meter reservations have a separate application and daily charge

For a metered loading location, budget the $10 application fee plus $23 for each meter on each requested day. Weekend days count. Submit at least two business days ahead and confirm the reservation before finalizing the driver's loading instructions. [1]

A change of use can need approval without construction

Moving furniture into a space does not settle whether your proposed use needs approval. Grand Rapids requires a change-of-use permit when the building or property's use changes without construction. Describe the previous and proposed uses to the Development Center at 616-456-4100 before fixing your occupancy schedule. [2]

Request a progress inspection for a tight renovation schedule

For permitted construction with a tight occupancy timeline, the city recommends a progress inspection at approximately 90 percent completion to identify outstanding issues. Request one through 311 inside city limits or 616-456-4100, Option 1, from outside the city. [3]

Choose the scope before requesting quotes

Your situationArrangeResolve before booking
Furniture and boxed contentsMoving crew with specified packing and assembly tasksInventory, access plan and written completion checklist
Computers, phones and shared printersMoving crew plus a named IT contactBackups, handling responsibilities and reconnection tests
Truck loading at city metersCity meter reservationApplication at least two business days ahead; permit and company logo display
Pod in the public right-of-wayTemporary Occupancy PermitCity arrangements before placing the pod
Renovated commercial premisesContractor coordination with the Development CenterRequired permits, inspections and Certificate of Occupancy before reopening
[1] [3]

Your hiring checklist

  1. Send bidders one inventory, destination layout and list of assembly tasks.
  2. Confirm loading access, elevator arrangements and building-manager contacts at both addresses.
  3. Assign responsibility for parking applications and any right-of-way arrangements.
  4. Record quote exclusions, waiting charges and the approval process for extra work.
  5. Name the people responsible for IT backups, disconnection and reconnection.
  6. Confirm any required premises approvals with the Development Center before setting the opening date.
  7. Agree on a walkthrough, damage record and equipment test before accepting completion.

Frequently Asked Questions

What should I include in an office moving quote request?

Include both addresses, your inventory, destination layout, access arrangements and requested work hours. Ask bidders to identify packing, assembly, IT tasks and storage as separate items. Require written terms for waiting time, additional trips and scope changes.

Can I reserve parking meters for the moving truck?

Yes. Grand Rapids accepts meter reservations for moving. Submit at least two business days before the reservation starts. The city charges $10 per application plus $23 per meter per day, including weekends, and handles requests on a first come, first serve basis. [1]

Does changing the use of the new office need a permit?

The city requires a change-of-use permit when you change a building or property's use without construction. Explain your proposed operation and the space's previous use to the Development Center so you can establish the approval steps before moving. [2]

When can staff return after an office renovation?

Grand Rapids requires a Certificate of Occupancy before reopening a renovated commercial building. The city issues it after the final building, electrical, mechanical, plumbing and other required inspections receive approval. Coordinate your staff return with that approval sequence. [3]

Sources and scope

This guide combines the sources below with practical planning guidance. Figures apply to the stated geography and period; request a written quote for your property.

  1. Reserve Parking MetersCity of Grand Rapids · City of Grand Rapids, Michigan · Checked 2026-10-15
  2. Commercial Building and Multiplex PermitsCity of Grand Rapids · City of Grand Rapids, Michigan · Checked 2026-10-15
  3. Planning and Permits for Commercial Renovation ProjectsCity of Grand Rapids · City of Grand Rapids, Michigan · Checked 2026-10-15
